The price shown on a dock leveler quotation is only one part of the project budget.
For a new loading dock, the final cost may also include pit construction, electrical work, export packaging, transportation, installation, commissioning, maintenance and replacement parts. Two dock levelers with similar dimensions can therefore lead to very different total project costs.
This is why comparing only the equipment price can be misleading.
A better way to evaluate dock leveler cost is to compare the same technical configuration, under the same trade terms, and then calculate the additional costs required to put the equipment into operation.
This guide explains where those costs come from, how to compare quotations correctly, and what buyers should consider when estimating the lifetime cost of a dock leveler.
A practical dock leveler budget can be divided into six main parts:
Total Project Cost = Equipment + Civil Work + Electrical Work + Logistics + Installation + Lifetime Maintenance
The importance of each item depends on whether the project is a new warehouse, an existing dock renovation or a replacement project.
The equipment itself normally represents the most visible part of the quotation.
However, even within the same product category, the price can change considerably depending on size, capacity, lip design, hydraulic components, structural reinforcement and safety configuration.
A larger platform requires more steel, stronger supporting beams and heavier structural components.
Capacity also affects the design.
A dock leveler intended for light pallet handling does not require the same structure as one carrying heavy forklifts and industrial cargo throughout the day.
The rated capacity should therefore be selected according to the real operating load rather than simply choosing the lowest-cost model.
The lip is another important cost factor.
A standard hinged-lip hydraulic dock leveler is usually simpler than a telescopic model with an extendable lip and additional hydraulic components.
Lip length may also change the structure and material requirement.
If a project requires greater trailer overlap or more accurate lip positioning, this should be confirmed before requesting quotations so every supplier is pricing the same configuration.

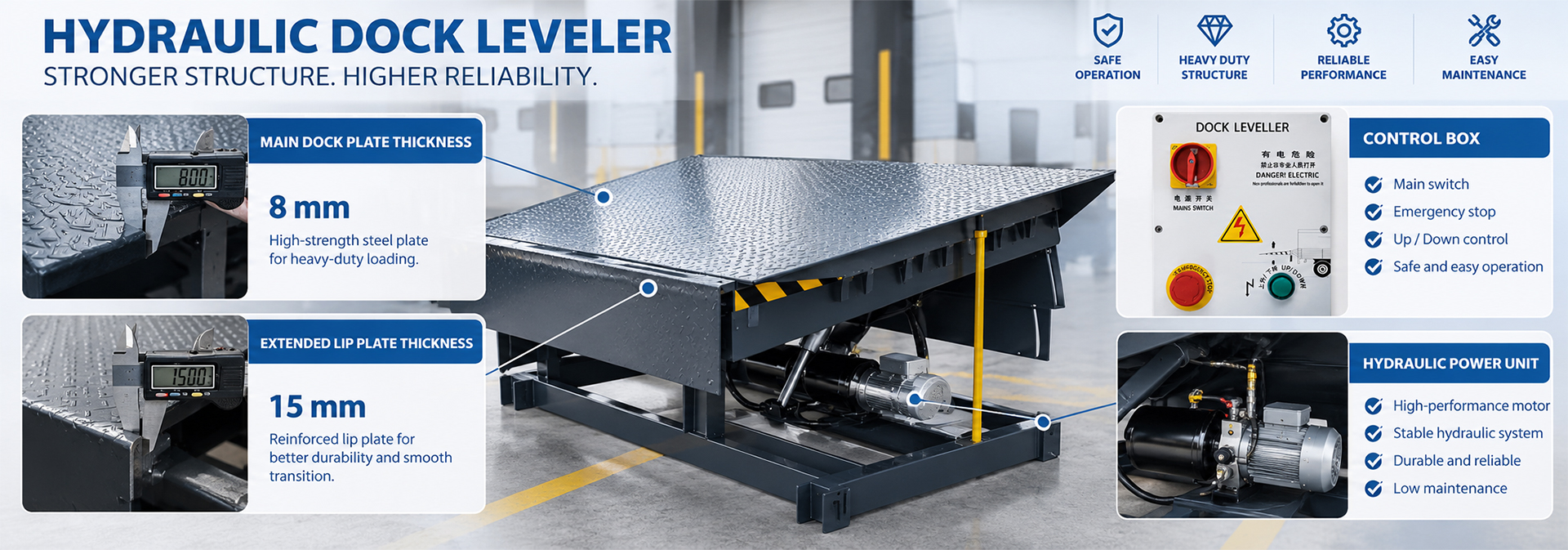

Platform thickness, reinforcement beams, lip construction, hinges and supporting frames all affect manufacturing cost.
Surface treatment matters as well.
A standard painted finish may be appropriate for an indoor warehouse, while galvanized steel or another corrosion-resistant treatment may be preferred for outdoor, humid or frequently washed environments.
The lowest-cost surface treatment is not always the lowest-cost option over the service life of the equipment.
For a hydraulic dock leveler, the power unit, hydraulic cylinders, valves, hoses, electrical components and control box are part of the equipment cost.
Different suppliers may use different component grades even when the platform dimensions look identical.
When comparing quotations, buyers should confirm whether the hydraulic power unit, control panel, emergency stop and related electrical components are included.
Safety equipment may be included as standard by one supplier and priced separately by another.
Depending on the design, these items may include:
Side toe guards
Maintenance support bar
Emergency stop
Hydraulic safety valve
Anti-slip platform surface
Safety warning labels
Dock bumpers
Traffic lights or warning devices
A lower equipment price can quickly become less competitive if basic safety components need to be added later.
For a pit-mounted dock leveler, the equipment cannot be considered separately from the building.
The pit must match the selected leveler dimensions and supporting structure.
New projects normally provide the best opportunity to control civil construction costs because the dock pit can be designed before the floor and loading platform are completed.
The equipment supplier should provide the required pit dimensions and installation drawing before construction begins.
Constructing a pit around an assumed dock leveler size can create unnecessary cost.
If the final equipment requires a different pit length, width or depth, concrete may need to be cut, rebuilt or reinforced.
For this reason, the equipment configuration and pit drawing should ideally be approved before civil work is finalized.
Retrofit projects can be more complicated.
The existing dock may already have a pit, embedded steel, damaged concrete or dimensions designed around older equipment.
The project may therefore require:
Concrete cutting
Pit enlargement or reduction
Structural reinforcement
New embedded steel
Welding work
Drainage modification
Floor repair
These costs are normally handled locally and may not appear on the dock leveler supplier's quotation.
Sometimes modifying the dock leveler to fit an existing pit is more practical than rebuilding the complete concrete structure.
In other cases, modifying the pit is the better long-term solution.
Both options should be evaluated before production begins.
Hydraulic dock levelers require electrical power for the hydraulic power unit and control system.
A supplier may provide the complete control box while the buyer remains responsible for connecting power at the site.
The local electrical budget may include:
Power cable
Cable tray or conduit
Circuit protection
Disconnect switch
Final connection
Control wiring
Electrical labor
Integration with other dock equipment
Voltage, phase and frequency should be confirmed before production.
Some facilities operate the dock leveler together with an industrial door, dock shelter, warning lights or other loading dock equipment.
If coordinated control is required, additional relays, sensors, electrical components or programming may be necessary.
This should be included in the technical scope before quotations are compared.
Dock levelers are heavy industrial products.
The equipment price may therefore represent only part of the amount required to move the unit from the factory to the project site.
International shipments normally require suitable protection for the platform, hydraulic system, control box and accessories.
Export packaging may include:
Protective wrapping
Reinforced supports
Wooden packaging
Moisture protection
Separate protection for electrical components
Buyers should confirm whether export packing is included in the equipment price or listed separately.
Transportation cost depends on equipment dimensions, weight, quantity, origin, destination and shipping method.
For international projects, possible logistics charges include:
Factory collection
Export handling
Ocean or inland freight
Destination handling
Customs clearance
Import duties and taxes
Final delivery to site
Unloading
Trade terms can make two quotations look very different.
An EXW quotation mainly represents the price available at the supplier's factory.
A FOB quotation includes additional export and delivery responsibilities up to the agreed port.
A CIF quotation adds international freight and insurance to the destination port.
Therefore:
A USD 4,000 EXW quotation is not automatically cheaper than a USD 4,500 FOB or CIF quotation.
The scope must first be normalized before price comparison.
Dock leveler installation is normally more involved than simply placing the equipment into the pit.
The unit must be positioned accurately, fixed to the supporting structure, connected electrically and tested under safe operating conditions.
Installation may involve:
Equipment unloading
Crane or forklift support
Positioning
Welding
Anchoring
Electrical connection
Hydraulic inspection
Control testing
Adjustment
Commissioning
Operator training
The supplier may provide installation instructions or technical support, while the physical installation is performed by a local contractor.
When a quotation states "installation available," buyers should confirm exactly what that means.
It may refer to remote technical guidance, technician supervision or complete local installation.
These are very different scopes and should not be treated as the same cost.
The most useful quotation comparison starts by fixing one technical specification.
Only then should different suppliers be compared.
For example, comparing an 8-ton standard hydraulic dock leveler with a heavier reinforced unit or a telescopic model does not reveal which supplier is more competitive.
It only compares different products.
The following table demonstrates how three anonymous quotations can be normalized.
Quotation Basis
Product: Hydraulic Dock Leveler
Quantity: 1 set
Platform size: 2000 × 2500 mm
Rated capacity: 8,000 kg
Lip: 600 mm hinged lip
Material: Q235 steel
Power supply: 380V / 3 Phase / 50Hz
Configuration: Hydraulic power unit + control box
Safety: Side toe guards + maintenance support
Trade term: EXW Shanghai
Currency: USD
Comparison date: September 2026
Important: The prices below are illustrative examples used to demonstrate quotation comparison methodology. They should not be treated as current market quotations.
Cost Item | Supplier A | Supplier B | Supplier C |
|---|---|---|---|
Basic equipment | $4,280 | $4,050 | $4,420 |
Hydraulic power unit | Included | Included | Included |
Control box | Included | Included | Included |
Side toe protection | Included | +$180 | Included |
Maintenance support | Included | Included | Included |
Pit installation frame | +$180 | +$210 | Included |
Export packaging | +$260 | +$340 | Included |
Comparable EXW Total | $4,720 | $4,780 | $4,420 |
Warranty | 2 Years | 1 Year | 2 Years |
At first glance, Supplier B appears to have the lowest price because its basic equipment price is USD 4,050.
Once the missing items are added, however, its comparable total becomes higher.
This is why the headline equipment price alone does not provide enough information for a purchasing decision.
Ask every supplier to quote against the same information:
Platform width and length
Rated capacity
Lip type and length
Platform material
Surface treatment
Hydraulic configuration
Electrical specification
Safety devices
Control functions
Accessories
Packaging method
Warranty
Quantity
Trade term
Destination if freight is requested
Knowing what is not included can be as important as knowing what is included.
A quotation should make clear whether the following are excluded:
Civil work, electrical wiring, unloading, installation, travel expenses, commissioning, customs charges, local taxes and spare parts.
This makes it much easier to build an accurate total project budget.
The lowest purchase price does not always produce the lowest lifetime cost.
Dock levelers operate under repeated forklift loading, impact, vibration and exposure to dust, water and changing environmental conditions.
Maintenance should therefore be considered during the purchasing stage rather than after problems occur.
Regular inspection can help identify wear before it develops into more expensive damage.
Maintenance areas commonly include:
Hinges and pivot points
Hydraulic hoses
Cylinders
Oil condition
Lip mechanism
Platform structure
Welds
Electrical controls
Safety components
Fasteners
A dock serving occasional deliveries does not experience the same wear as a distribution center handling trucks throughout the day.
Maintenance planning should reflect loading frequency, forklift weight, operating environment and equipment condition.
Hydraulic seals, hoses, electrical components, switches and other wear parts may eventually require replacement.
Before purchasing, buyers should understand:
Which parts are standard
Which parts are supplier-specific
Typical spare-parts availability
How replacement parts are identified
Whether technical drawings and manuals are supplied
Easy access to replacement parts can reduce future downtime.
The direct cost of replacing a component may be relatively small compared with the operational impact of an unavailable loading bay.
If one dock is out of service, trucks may need to wait, move to another bay or reschedule loading.
For high-volume warehouses, equipment reliability therefore has an economic value beyond the maintenance invoice.
A useful lifetime cost calculation is:
Lifetime Cost = Initial Project Cost + Planned Maintenance + Replacement Parts + Unplanned Repairs + Downtime
The exact values will vary between facilities, but the principle remains the same.
A higher initial price can be justified when the upgraded configuration directly matches the operating conditions.
The goal is not to buy the most expensive dock leveler.
The goal is to avoid paying for the wrong one.
A high-volume logistics facility may benefit from stronger structural components and a hydraulic system designed for frequent operation.
Choosing an underspecified model simply to reduce the initial equipment cost can increase wear and maintenance requirements later.
Projects exposed to rain, humidity, salt or frequent washing may require improved corrosion protection.
The additional surface-treatment cost should be compared with the future cost of coating repairs and corrosion damage.
Where truck bed heights and trailer configurations vary significantly, a more suitable platform size, working range or lip design may improve daily operation.
In these situations, reducing the equipment specification to save purchase cost can create operational limitations.
An upgrade is worthwhile when it solves a real operating problem.
If the standard configuration already meets the project requirements, unnecessary upgrades simply increase the project budget.
Cost control should focus on removing unnecessary expense rather than removing necessary performance.
Changes after production begins can create additional engineering, material and scheduling costs.
Before placing the order, confirm:
Truck bed height range
Dock height
Pit dimensions
Forklift weight
Maximum cargo load
Loading frequency
Power supply
Environmental conditions
Required safety functions
If a project requires several dock levelers, using the same size and configuration where possible can simplify production, installation and future spare-parts management.
When several loading bays use the same hydraulic, control and safety components, the maintenance team needs fewer types of replacement parts.
This can simplify long-term inventory and technical support.
Incorrect pit dimensions, missing electrical preparation and unplanned unloading requirements are common sources of avoidable project cost.
A confirmed installation drawing allows the local construction and electrical teams to prepare the site before delivery.
Reducing USD 100 from the equipment price has little value if the resulting configuration creates USD 1,000 of additional site work.
The purchasing team should therefore negotiate around the complete project scope, not only the factory price.
A detailed RFQ makes quotations easier to compare and reduces the risk of later price changes.
Provide:
Existing dock height
Existing pit dimensions
New construction or retrofit
Site photos or drawings
Available installation space
Provide the minimum and maximum truck bed heights and the types of vehicles using the dock.
Quoting around one truck may not represent the real operation if several vehicle types use the same loading bay.
Provide:
Forklift weight
Maximum cargo weight
Pallet or load type
Approximate daily loading frequency
This information helps determine the required structural capacity.
Also include:
Voltage
Phase
Frequency
Installation country
Delivery destination
Required quantity
Preferred trade term
Required completion date
The more complete the information is, the easier it becomes to receive quotations based on the same technical scope.
There is no single standard dock leveler price.
Cost depends on dimensions, rated capacity, lip design, structural configuration, hydraulic components, controls, safety devices, surface treatment, quantity and delivery terms.
A useful quotation should therefore be based on a defined technical specification rather than a generic unit price.
Hydraulic systems normally contain additional power, control and hydraulic components, which can increase initial equipment cost.
However, purchase price alone should not determine the selection.
Operating frequency, workforce requirements, maintenance strategy and loading conditions should also be considered.
Not necessarily.
Some suppliers quote equipment only, while others may provide installation guidance, technician supervision or complete installation services.
Always confirm the exact installation scope before comparing quotations.
It can, particularly for retrofit projects.
New warehouse pits can normally be planned around the selected equipment.
Existing docks may require concrete cutting, reinforcement, new embedded steel or dimensional modifications.
Confirming the equipment drawing before construction helps reduce these risks.
Provide the supplier with the dock height, pit size, required platform size, truck height range, forklift weight, cargo weight, loading frequency, power supply, quantity and project location.
If freight is required, also specify the delivery destination and preferred trade term.
A dock leveler should not be purchased by comparing one number at the bottom of a quotation.
The real project budget includes the equipment, civil work, electrical preparation, packaging, transportation, installation and future maintenance.
More importantly, quotations should only be compared after the technical specification and commercial scope have been normalized.
A lower equipment price may exclude safety components, packaging or installation accessories. A more expensive quotation may already include items that would otherwise need to be purchased separately.
The best approach is therefore simple:
Define the same configuration → compare the same scope → calculate the installed cost → consider the lifetime cost.
This gives purchasing teams a much clearer view of what the loading dock project will actually cost.
For project-specific dimensions, capacities and configurations, explore our Dock Leveler solutions or contact EVERBESTEN with your dock dimensions, truck information and loading requirements for a detailed quotation.
Dock Leveler Cost Guide: Equipment, Installation And Lifetime Costs
High Speed Door Types And Applications: PVC Fabric, Zipper, Spiral And Cold Storage
Dock Shelter Sizing Guide: Width, Height, Projection And Truck Compatibility
Loading Dock Safety Checklist And Best Practices for Warehouse Managers
PVC High Speed Door vs. Zipper High Speed Door: Key Differences and How to Choose
Types of High Speed Doors: A Practical Guide To Zipper, Spiral, PVC Fabric, And Cold Storage Models
Loading Dock Design Guide: Dock Height, Door Dimensions And Dock Leveler Selection
Dock Leveler Installation Guide: Pit Sizes, Power Requirements And Safety Checks
Mechanical Dock Shelter Troubleshooting Guide: Poor Sealing, Curtain Damage, And Projection Problems
